Upcoming improvements to Coast Village Road in 2024!!

Navigate the 2022 CBID


Upcoming Improvements

The City of Santa Barbara will begin upgrades to the curbs and gutters while adding loading zones for deliveries, to alleviate the delivery trucks parking in the medians. This work will happen one median section at a time on Coast Village Road – beginning at the west end of the Coast Village Circle intersection, and ending at the east end of the Coast Village Circle intersection. The targeted time frame is Spring of 2024, beginning March 25, 2024, and plan to end in advance of the Memorial Day weekend. Work will take place from 7 a.m. – 5 p.m., Monday through Friday.

Updates will be available on this page, as we get new information.

Click to enlarge

Prep Work Monday, March 25 - Monday April 1, 2024

FINISHED

Granite begins preparing for the curbs and gutter construction on Coast Village Road’s medians.

   The following will occur the week of 3/25/2024

 Sawcutting

  • This operation will be performed to prepare the areas designated for demolition and improvements* and will involve sawcutting the concrete or asphalt pavement around the proposed improvements.

  • This will take place over a 3-4 day period, weather permitting.

* How to tell if an area is designated for sawcutting! If you see orange paint on the asphalt, curbs or sidewalks near you, this area is going to be affected.

  • The NO PARKING will only be valid and be enforced for the dates noted on the signs.

  • As the work is completed, the NO PARKING signs will be removed.

First Median: Beginning April 3, 2024

Finished

Businesses affected:

First American Title • Sotheby’s • Paseo Mariposa (1165) • Chase Bank
Coast Village Plaza (1187) • 1180 CVR • Coast Village Inn • Olivers

Merchants: Please notify your delivery services that they should use Coast Village Circle, when applicable, and that deliveries may be more difficult with less access to the business via Coast Village Road.

Granite begins replacing the curbs and gutters on Coast Village Road’s medians. The first work will begin at the median in front of 1187 Coast Village Road, encompassing all businesses facing that median.

Each median will be “under construction” for approximately two weeks. Durations may fluctuate:timing depends on weather, major accidents, and unforeseen issues.

Parking spaces in front of the businesses listed will be closed during construction.

NO PARKING SIGNS will be placed no less than 72 hours in advance.

Beginning April 1, 2024

FINISHED

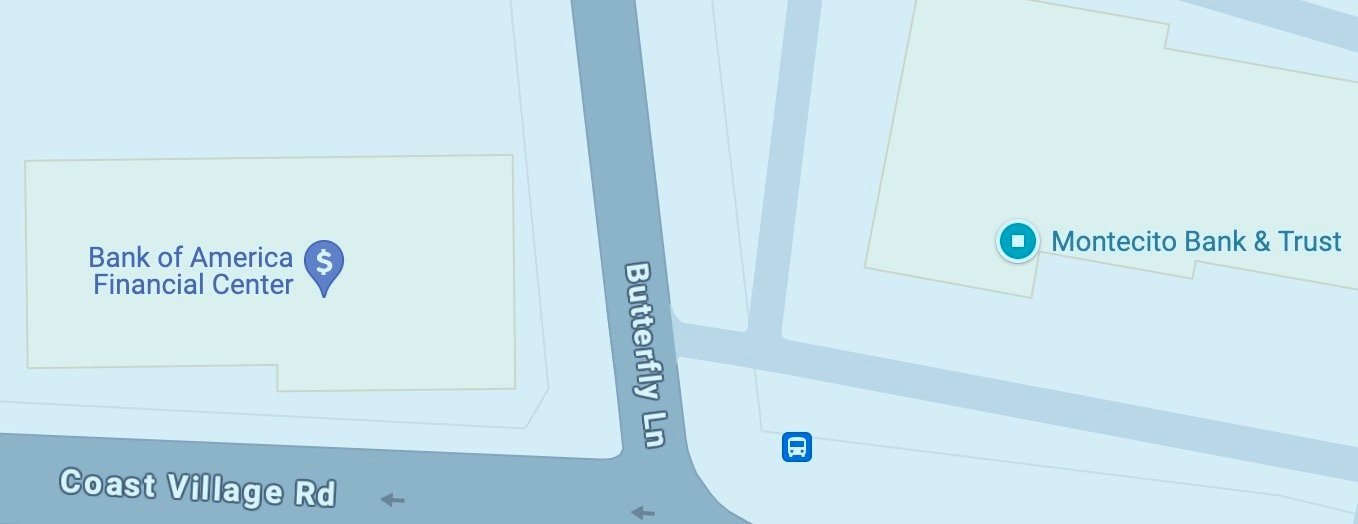

At the intersection of Butterfly Ln & Coast Village Rd, there will be an intersection realignment project under construction.

The construction crew will attempt to get this closed up before the rain this Friday, April 5th.

This intersection will remain closed until Monday, April 7th.

Businesses affected will include Bank of America, and Montecito Bank & Trust.

Beginning Monday April 8, 2024

Finished (Eastside)

At the intersection of Middle Road & Coast Village Rd, there will be an access ramp installation under construction.

Traffic going up Middle Road will be closed intermittently, and the crew will be attempting to keep the road open heading down onto CVR.

Businesses affected will include The Bottle Shop, and Oliver’s.

Median #2: Beginning April 15, 2024

ONGOING - Scheduled to finish early the week of April 22, 2024

Finished

Businesses affected:

Whiskey x Leather • COMPASS • Morgan Stanley • True Love Always
Pacific Architects • SAGE IV & Aesthetics • Montecito Concierge Medicine
Merchants: Please notify your delivery services that deliveries may be more difficult with less access to the business via Coast Village Road.

Granite begins replacing the curbs and gutters on Coast Village Road’s medians.

Work will take place from 7 a.m. – 5 p.m., Monday through Friday.

Each median will be “under construction” for approximately ten days. Durations may fluctuate: timing depends on weather, major accidents, and unforeseen issues.

Parking spaces in front of the businesses listed will be closed.

NO PARKING SIGNS will be placed no less than 72 hours in advance.

Beginning Monday April 22, 2024

at K Frank and Villa Fonatana

Finished

At the crosswalk from Villa Fontana to Tre Lune there will be a crosswalk upgrade under construction.

In front of K Frank there will be an Island reconstruction project

Businesses affected will include K Frank (3 parking spaces will be posted “no parking.

Residents affected will be Villa Fontana.

Beginning April 22, 2024

FINISHED

Businesses affected:

Chevron and The Point Market (Carwash) and Coast Village Circle Merchants

Granite be re-aligning the crosswalk and ramps at the intersection of Coast Village Circle (West) and Coast Village Road.

Work will take place from 7 a.m. – 5 p.m., Monday through Friday.

This construction will take place as quickly as possible and aims to be finished this week but could go for approximately ten days as durations may fluctuate: timing depends on weather, major accidents, and unforeseen issues.

NO PARKING SIGNS will be placed no less than 72 hours in advance.

Road Closure

Coast Village Circle will be closed to through traffic and open to local traffic only, at Chevron heading East.

Westbound Coast Village Circle will be open at Honor Bar to through traffic .

Beginning Monday April 22, 2024

at Oliver’s (Westside of CVR)

ONGOING DUE TO COMPLICATIONS

At the intersection of Middle Road & Coast Village Rd, there will be an access ramp installation under construction on the Westside of the intersection near Oliver’s.

Traffic going either direction on Middle Road can be closed intermittently, and the crew will be attempting to keep the road open as much as possible.

Businesses affected will include The Bottle Shop, and Oliver’s.

Median #3: Beginning April 29, 2024

Businesses affected:

Renaud’s• City National Bank• Lilac • The Nurture Cottage

Residents’ affected:

1220 Coast Village Road “Coast Village Gardens”

Median in front of businesses from 1205, 1209, and 1213 CVR

Granite begins replacing the curbs and gutters on Coast Village Road’s medians.

Work will take place from 7 a.m. – 5 p.m., Monday through Friday.

Each median will be “under construction” for approximately ten days. Durations may fluctuate: timing depends on weather, major accidents, and unforeseen issues.

Parking spaces in front of the businesses listed will be closed.

NO PARKING SIGNS will be placed no less than 72 hours in advance.

Median #4: Beginning April 29, 2024

Mountain side only

Businesses affected:

This will affect Olive Mill Plaza Businesses due to noise, but parking will be available. This median work will take place next week. May 6, 2024.

Residents’ affected:

1220 Coast Village Road “Coast Village Gardens”

Median in front of Coast Village Road Gardens

Granite begins replacing the curbs and gutters on Coast Village Road’s medians on the traffic side of the road (mountain side)

Work will take place from 7 a.m. – 5 p.m., Monday through Friday.

Each median will be “under construction” for approximately ten days. Durations may fluctuate: timing depends on weather, major accidents, and unforeseen issues.

Parking spaces in front of 1220 CVR will be closed.

NO PARKING SIGNS will be placed no less than 72 hours in advance.

Beginning Monday April 29, 2024

at Renaud’s Patisserie and Richie’s Barber Shop

There will be an Island construction project.

Businesses affected will include Renaud’s, Richie’s, Juice Ranch, CaDario, Halo and Horns

We have been alerted that a city walk through has motivated miscellaneous sidewalk repairs along the CVR corridor!

Tree roots are causing hazardous conditions and this is for the safety of all pedestrians. These will be taking place mostly on the mountainside of the road over the course of the project.

Letter from the Executive Director

Paving the Way to Progress

The City of Santa Barbara and Coast Village Association are paving the way for a better district… literally!

Over the past eight years Montecito, and Coast Village Road have endured many challenges. We have experienced droughts, rain events, winds, the Thomas fire and the subsequent devastating debris flow, as well as the pandemic. As a result, the region’s roads and medians have deteriorated. We thank our residents, businesses, and property owners for the resilience and heart they have shown us throughout these years!

The Coast Village Improvement District was created in 2023 to enhance the districts’ beautification, safety, marketing, and maintenance needs, while working with the city of Santa Barbara, and other stakeholders towards our mission. Over the past year, we have been working diligently toward these goals. This year, we are moving forward with building new infrastructure for businesses, traffic, safety, and beautification of the physical road through a road paving, and commercial loading zone project.

This project marks a significant stride towards our shared vision of a vibrant community and reflects our unwavering commitment to enhancing safety, accessibility, and the overall aesthetic appeal of our district.
— Beth Sullivan, Executive Director

Residences and businesses alike are poised to benefit from the upcoming road paving of Coast Village Road, and a wave of positive changes to better the district. The plan is to start with curb and gutter work in the Spring and re-paving in the Fall, all to be completed in 2024. While adjustments may be necessary during construction, this endeavor promises enduring advantages for all. This project will cause a temporary disruption to businesses and the community. Efforts will be coordinated for minimal inconvenience, with work scheduled thoughtfully, and communication channels kept open.

The City of Santa Barbara will begin with upgrades to the curbs and gutters while adding loading zones for deliveries to alleviate the delivery trucks parking in the medians. This work will happen one median section at a time on Coast Village Road – beginning at the west end of the Coast Village Circle intersection, and ending at the east end of the Coast Village Circle intersection.

The targeted time frame is Spring of 2024, beginning March 25, 2024, and is planned to end in advance of the Memorial Day weekend. Each median will take up to two weeks, and work is planned from 7 a.m. – 5 p.m. The angled parking directly adjacent to the section where the work is taking place will be used for construction vehicles and materials during each section’s schedule. As a result, this parking will be unavailable and clearly marked “no parking”. Compliance will be key to the completion of this project in a timely manner.

Looking beyond the short-term adjustments, the loading zone and road paving project symbolizes a commitment to the mission of Coast Village Improvement District to better our community, and increase safety. Improved infrastructure not only facilitates smoother travel but also catalyzes economic growth while enhancing community vitality. Through this endeavor, we ask the community to embrace this as progress for fostering betterment, and laying the groundwork for beautification of the medians.

We appreciate your understanding and patience while we pave our way to a better Coast Village Road.
